DC1300T / Heavy-cell engineering blueprint

1300 Ton Aluminum Cold Chamber Die Casting Machine

The DC1300T is a 13,000 kN cold chamber platform for large aluminum and magnesium projects. Its value depends on more than clamp force: the casting, complete shot, die movement, thermal process, automation, building services, acceptance evidence, and supply boundary must resolve into one buildable production-cell plan.

Published DC1300T data reviewed August 10, 2026 by Cathy, Director. Final approved drawings and the signed technical agreement govern the supplied configuration.

BLUEPRINT REFERENCE / DC1300TDC1300T 1300 ton aluminum cold chamber die casting machine engineering visualization with English model marking
Engineering visualization based on a published heavy cold chamber machine reference. Confirm final geometry, component makes, guarding, colors, shot end, automation, options, and supply scope in approved project documents.

Blueprint 01 / Model-fit logic

Six calculations must converge before the machine is approved

Engineering, tooling, automation, plant, quality, and purchasing should work from the same controlled inputs. A red condition in any lane keeps the model open; a green result in all six lanes supports a defensible technical shortlist.

01

Clamp demand

Total every pressure-exposed projected area, state the cavity-pressure basis, alloy, slide effects, quality risk, and margin. Compare the signed result with 13,000 kN.

Evidence: calculation sheet
02

Complete shot

Include all castings, runners, biscuit, overflows, and process allowance. Verify weight and required intensification pressure against one exact shot-end package.

Evidence: mass balance
03

Die envelope

Check width, height, 450-1,200 mm thickness, weight, mounting, opening, ejection, slides, core pulls, cooling, vacuum, lifting, and changeover.

Evidence: interface drawing
04

Process window

Define fill profile, velocity, pressure, thermal control, vacuum, spray, metal temperature, die temperature, quality criteria, inspection, and traceability.

Evidence: process basis
05

Cell performance

Freeze cycle definition, annual volume, shifts, OEE assumptions, furnace, dosing, extraction, trim, conveyors, inspection, scrap routing, and recovery logic.

Evidence: time study
06

Factory and delivery

Approve transport, lifting, foundation, utilities, safety, service zones, destination rules, FAT, SAT, documentation, training, spares, and warranty ownership.

Evidence: project execution plan

Blueprint 02 / Pressure-capacity envelope

Request the complete shot-end matrix before choosing a plunger

The manufacturer publishes boundary ranges for the DC1300T rather than a complete set of paired values. Do not interpolate those values into a purchase decision. Ask the quotation to state aluminum and magnesium capacity, intensification pressure, casting area, sleeve dimensions, and injection position for every offered plunger diameter.

Selection rule

The approved package must clear complete shot while preserving the required intensification pressure and agreed process margin.

Pressure-ledCapacity-led
Plunger diameter100-140 mm

Confirm the exact offered diameters and sleeve interfaces.

Aluminum shot range13-36 kg

Use complete shot, not net casting weight.

Magnesium shot range9.3-18.7 kg

Confirm alloy basis and real process allowance.

Intensification pressure140-71 MPa

Published pressure decreases toward the capacity-led end.

Published casting area885-1,735 cm2

Geometry and cavity pressure still govern actual fit.

Blueprint 03 / Controlled data sheet

DC1300T technical specifications

These published values support model screening and RFQ preparation. Final approval requires project-specific datums, tolerances, component schedules, interface drawings, utility loads, foundation information, and the signed technical agreement.

03-A

Clamping and die interface

Clamping force
13,000 kN
Clamping stroke
1,000 mm
Ejecting force
550 kN
Ejection stroke
200 mm
Die thickness range
450-1,200 mm
Platen size
1,730 x 1,730 mm
Tie-bar diameter
230 mm
Tie-bar spacing
1,100 x 1,100 mm
03-B

Injection and shot end

Injection force
1,100 kN
Injection stroke
910 mm
Plunger diameter range
100-140 mm
Aluminum shot range
13-36 kg
Magnesium shot range
9.3-18.7 kg
Intensification pressure range
140-71 MPa
Published casting area
885-1,735 cm2
Maximum casting area
3,125 cm2
Injection positions
-160 / -320 mm*
Plunger launch distance
350 mm
Shot-chamber flange
240 mm diameter
Flange protrusion
25 mm
03-C

Power and installation

Motor power
75 kW
System pressure
16 MPa
Oil tank capacity
2,000 L
Approx. machine weight
95 t
Approx. machine size
11 x 4.0 x 4.5 m
Listed materials
Aluminum / magnesium
Published slow-shot range
0.1-1.4 m/s
Published max. air-shot speed
At least 7 m/s

Source: current manufacturer-published DC1300T data, reviewed August 10, 2026 by Cathy, Director | *Confirm injection-position datums and available settings in the approved drawing | Signed technical documents take precedence.

Published manufacturer reference: ShiMi DC1300T Standard Cold Chamber Die Casting Machine. Use this public record to cross-check the web summary; approved supplier drawings and the signed technical agreement govern the final configuration.

Blueprint 04 / Maintainability review

Inspect service zones before they become downtime risks

These official system references have been cleaned of Chinese and brand text. They show typical component families and access questions, not a guarantee of the final make, quantity, layout, color, or included scope.

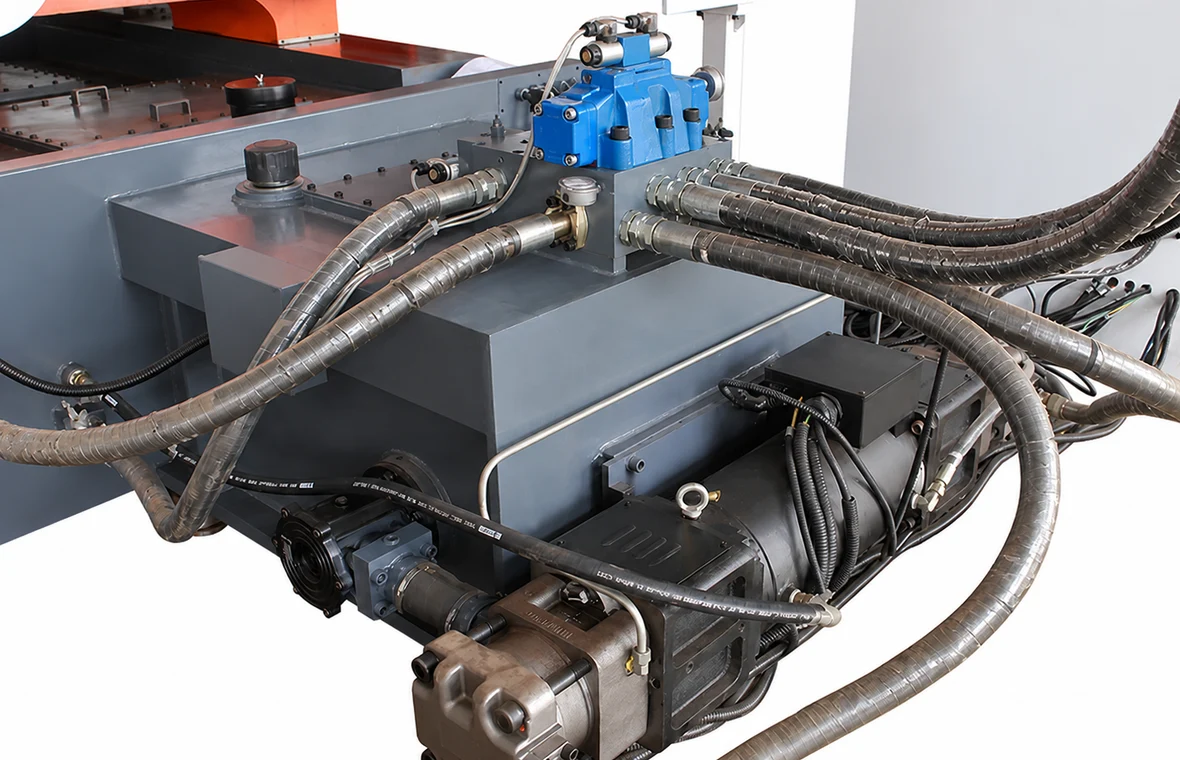

SYS-01Heavy cold chamber die casting machine hydraulic distribution block, hoses, pump, fittings, and service area without Chinese labels

Hydraulic distribution and service access

Use the interface review to freeze component makes, filtration, oil grade, temperature limits, cooling duty, isolation method, hose and seal spares, diagnostic points, lifting access, safe maintenance zones, and the drawings delivered for the installed circuit.

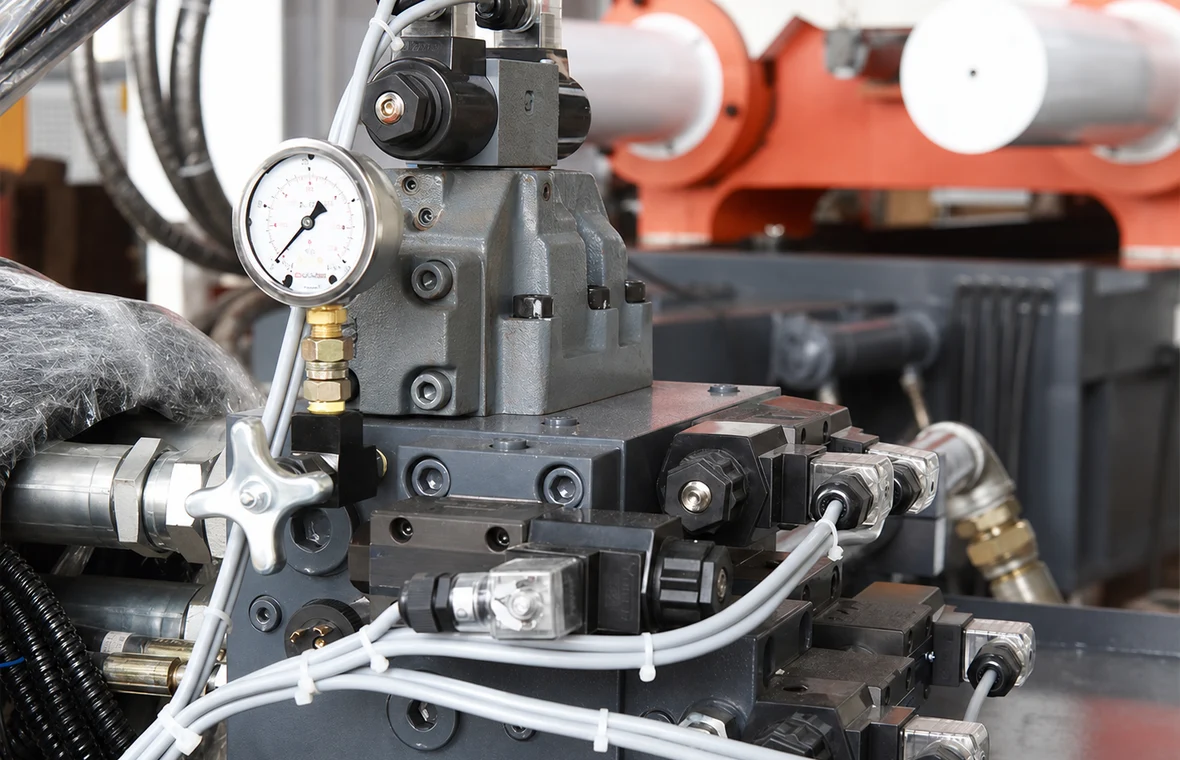

SYS-02Heavy cold chamber die casting machine pressure control valve, gauge, solenoids, wiring, and fittings without Chinese labels

Pressure regulation and acceptance evidence

The signed test plan should state calibration points, pressure and velocity measurements, accumulator discharge procedure, repeatability sample, alarm and interlock checks, replacement parts, data format, and the exact pass criteria used during FAT and SAT.

Blueprint 05 / 95 ton site plan

Design the building interfaces around the installed cell

The published 11 x 4.0 x 4.5 m dimensions describe the base machine. Furnace, dosing, spray, extraction, trim, guarding, platforms, piping, die handling, access, and maintenance zones expand the final footprint and connected loads.

95 tpublished machine mass
before peripherals
P01

Shipping route

Freeze packing split, transport dimensions and weights, port and road limits, unloading equipment, doorway and aisle clearance, floor transitions, center of gravity, lifting points, crane capacity, hook height, rigging, and final-positioning responsibility.

P02

Foundation and die handling

Approve floor load, pits, anchors, leveling, grout, drainage, oil containment, vibration criteria, crane coverage, die-change route, storage, tie-bar and platen service, accumulator access, electrical-panel clearance, and safe escape paths.

P03

Utilities and heat rejection

State voltage, frequency, transformer and cable boundary, connected and operating demand, cooling-water flow, pressure and quality, compressed air, oil cooling, furnace energy, exhaust, network, connection locations, and local distribution ownership.

P04

Safety and compliance

Define applicable standards, risk-assessment responsibility, guarding, interlocks, emergency zones, stairs and platforms, lockout points, hot-metal hazards, operator sightlines, labels and language, validation records, environmental obligations, and permits.

Blueprint 06 / Execution sequence

Make deliverables visible at every project gate

A large machine order needs a controlled information flow. Each gate should end with approved documents, named owners, open-action dates, and a clear rule for proceeding, holding, or changing scope.

  1. G1

    Technical freeze

    Approved casting basis, clamp calculation, complete shot, shot end, die interfaces, process requirements, cell scope, safety concept, utilities, and exclusions.

    Release: signed specification
  2. G2

    Design approval

    General arrangement, foundation, interfaces, component schedules, electrical and pneumatic diagrams, I/O, risk review, service access, and document register.

    Release: approved drawings
  3. G3

    Factory acceptance

    Safety, motion, die protection, injection stages, pressure build, repeatability, alarms, recipes, interfaces, sample conditions, records, pass criteria, and open actions.

    Release: FAT record
  4. G4

    Delivery and SAT

    Packing, shipment, unloading, positioning, installation, commissioning, production trial, capability evidence, training, manuals, backups, spares, warranty start, and final handover.

    Release: acceptance certificate

Blueprint 07 / Commercial normalization

Compare responsibility and evidence before comparing price

Require each bidder to mark every line Included, Optional, By Buyer, or Excluded, with a technical reference and price effect. This makes hidden integration work, lifecycle costs, and commissioning risks visible before order placement.

S1

Machine configuration

Selected shot end, controls, hydraulics, core pulls, lubrication, cooling interfaces, guarding, die protection, options, component makes, oil charge, colors, certifications, and exclusions.

S2

Cell and data

Furnace, dosing, spray, extraction, quench, trim, conveyors, scrap, inspection, vacuum, thermal control, I/O, recipes, traceability, network, safety integration, and cycle ownership.

S3

Delivery services

Incoterm, packing, insurance, freight, unloading, foundations, piping, cabling, installation, commissioning, sample material, production support, local labor, permits, and utilities.

S4

Lifecycle package

Drawings, manuals, certificates, software, backups, FAT and SAT records, training, translations, included and recommended spares, warranty, remote support, service response, and escalation path.

Blueprint 08 / Procurement FAQ

Answers that connect model selection to project execution

Use these answers for early screening, then place project values, calculations, drawings, responsibilities, tolerances, test conditions, and acceptance evidence into the signed technical agreement.

Q01What projects should shortlist the DC1300T aluminum die casting machine?

The DC1300T is an initial candidate for large aluminum or magnesium projects whose verified clamp demand, complete shot, die envelope, pressure requirement, automation, and plant interfaces fit the published 13,000 kN platform. The 1,300 ton name does not approve a casting or justify unused capacity without calculations.

Q02What are the principal DC1300T technical specifications?

Published data lists 13,000 kN clamping force, 1,000 mm clamping stroke, 550 kN ejecting force, 200 mm ejection stroke, 450-1,200 mm die thickness, 1,730 x 1,730 mm platens, 1,100 x 1,100 mm tie-bar spacing, 1,100 kN injection force, 910 mm injection stroke, 75 kW motor power, a 2,000 L oil tank, and approximate 95 ton machine weight.

Q03How should a DC1300T shot-end package be selected?

Published ranges cover 100-140 mm plunger diameters, 13-36 kg aluminum shot, 9.3-18.7 kg magnesium shot, 140-71 MPa intensification pressure, and 885-1,735 cm2 casting area. Request the exact paired values for every offered diameter, then select against complete shot and required pressure together.

Q04How do I check whether 13,000 kN clamping force is sufficient?

Total the pressure-exposed projected area of all cavities, runners, overflows, and slides, multiply by the agreed cavity-pressure basis, and apply the documented operating margin. Check the result against 13,000 kN separately from shot capacity, die fit, and the published 3,125 cm2 maximum casting area.

Q05What factory planning is required for a 95 ton DC1300T?

Approve the shipping split, transport and unloading route, lifting equipment, center of gravity, foundation, anchoring, floor load, 11 x 4.0 x 4.5 m bare-machine envelope, die-change route, crane coverage, maintenance zones, electrical supply, cooling water, air, exhaust, oil cooling, guarding, and every peripheral footprint from final drawings.

Q06What should a comparable DC1300T quotation and acceptance plan contain?

Require the selected shot end, controls, hydraulics, core pulls, cooling and vacuum interfaces, automation ownership, safety scope, utilities, drawings, manuals, software backups, spares, packing, installation, training, warranty, and exclusions. FAT and SAT should define test conditions, measurements, records, pass criteria, corrective actions, and retest responsibility.

DC1300T project-input package

Send the evidence needed to engineer the complete cell

A useful response should identify model fit, the exact shot-end package, die and automation interfaces, preliminary factory requirements, acceptance path, commercial boundary, open assumptions, and the owner of each next action.

  • 01 / CASTING

    Alloy, drawings, projected area, cavity-pressure basis, cavities, net weight, runners, biscuit, overflows, complete shot, fill, quality, inspection, and traceability.

  • 02 / DIE

    Dimensions, thickness, weight, mounting, opening, ejection, slides, core pulls, cooling, vacuum, lifting, storage, and changeover method.

  • 03 / CELL

    Cycle definition, annual volume, shifts, OEE basis, furnace, dosing, spray, extraction, quench, trim, inspection, scrap, guarding, I/O, data, and recovery.

  • 04 / FACTORY

    Layout, route, foundation, crane, utilities, safety standard, destination, Incoterm, FAT, SAT, documents, installation, training, warranty, and spares.

Get a Quote WhatsApp
